28/6/2018
Meeting with TNB relocation work subcontractor (SEP engineering). The meeting cover critical works that need to be completed on package 1 and package 2 span. Work planning is crucial in completing project in time.
In the afternoon, M&E team went for a site walk along package 1 span. To keep in track of civil works, we need make sure M&E work platform are ready. Some of the M&E relocation work need C&S structure to reach certain level before relocation can be done, I.E. relocation at CH 10100; Cable relocation can only be done after civil remove and replace (R&R) is finished and before road is filled to final level.

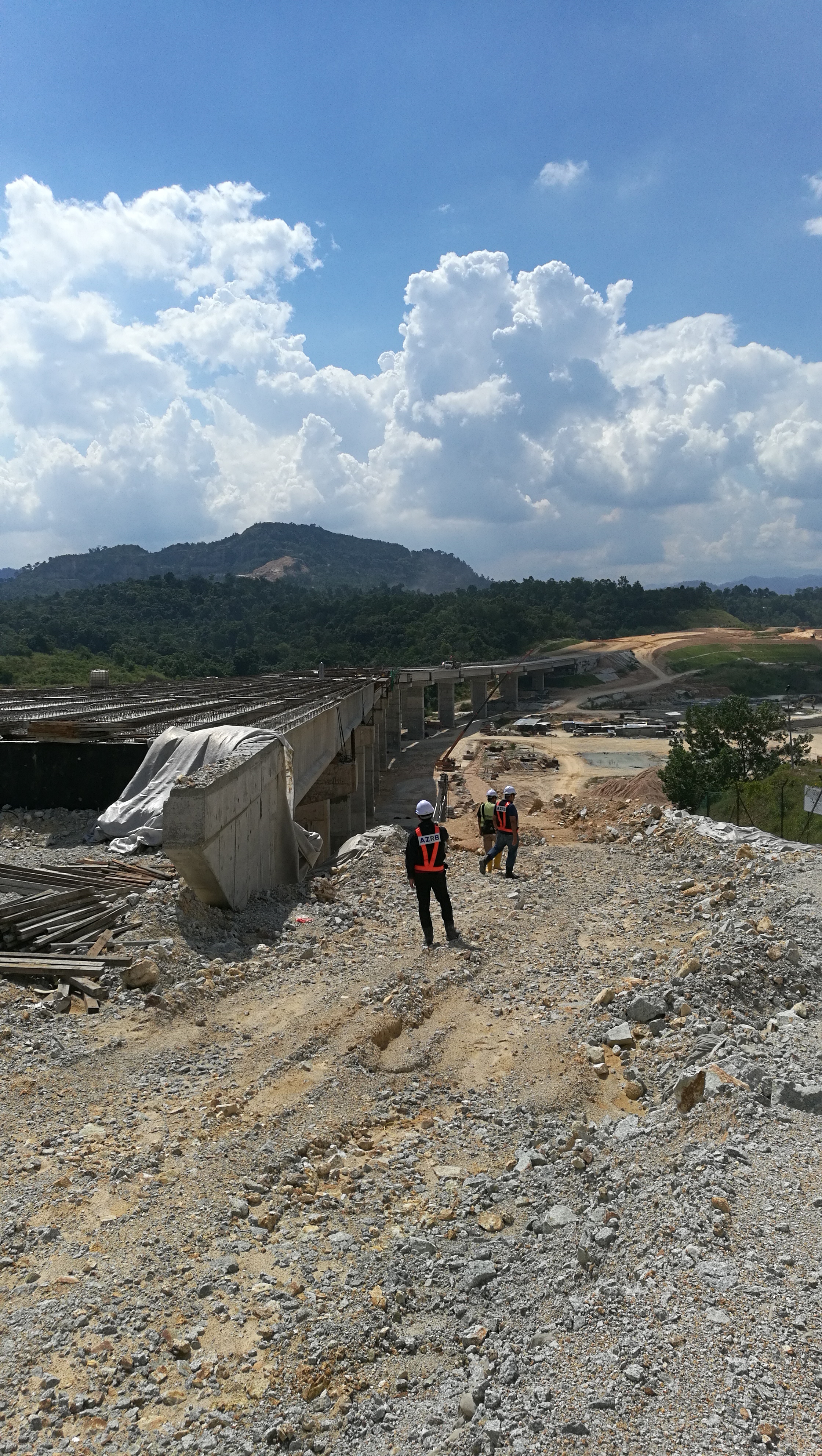

Bridge 8 progress

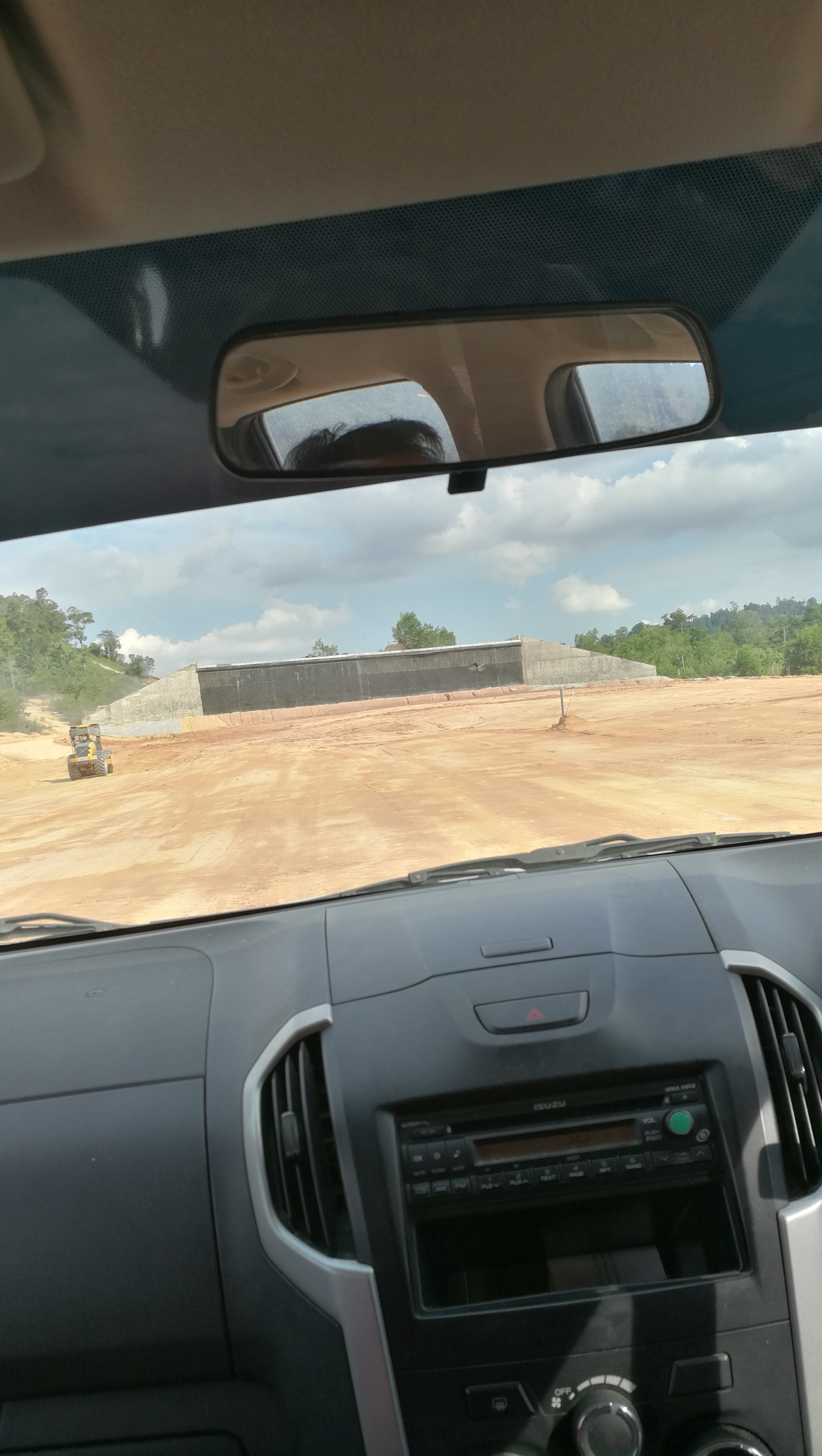

Ch 10100 Vehicular box culvert progress R&R
29/6/2018
Assisted M&E engineer to investigate electrical wiring complication at main site office. We planned the solution to be executed later.
30/6/2018
Diagnosed yesterday's wiring problem with M&E supervisor.
